Share Dubail Avenue Streetscape Improvement Project on FacebookShare Dubail Avenue Streetscape Improvement Project on TwitterShare Dubail Avenue Streetscape Improvement Project on LinkedinEmail Dubail Avenue Streetscape Improvement Project link
PROJECT BACKGROUND
As part of its implementation of the Southeast Neighborhood Master Plan, the City of South Bend is making streetscape improvements along Dubail Ave between Michigan and Miami streets. Per the master plan, these improvements focus on providing a sense of place and improving walkability and bike-ability.

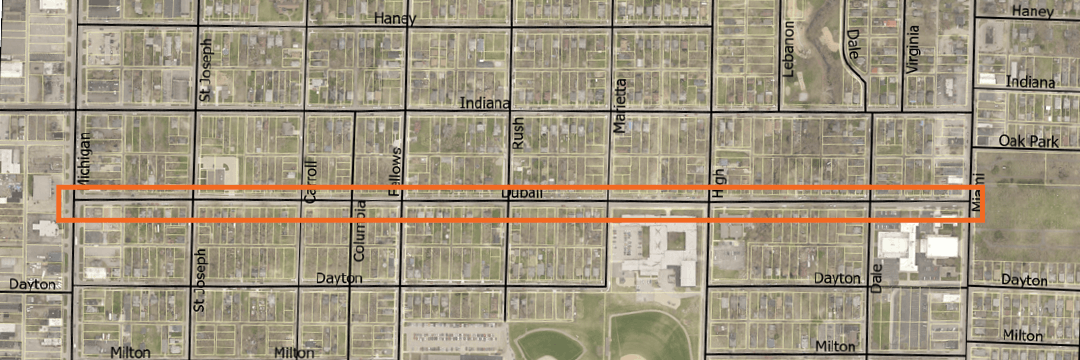

PROJECT AREA The project area will be made to the 10-block section of Dubail Ave between Michigan & Miami streets. Street trees will be planted within the tree lawn (area between curb and sidewalk) in May 2022.
Items to be replaced
Items to be added
Items to be removed
ADA curb ramps
Alley and driveway approaches
Curbs
Sidewalks (areas in less than good condition only)
Drainage structures at intersections
Street paving at intersections
Pedestrian bumpouts at each intersection
Street trees
Driveway approaches that are no longer needed or can be consolidated.
Street trees that are dead, dying or in poor health
PROJECT SCHEDULE
Phased construction is scheduled to begin before end of October 2021. Work on the following phase to begin once current phase is complete. All dates are subject to change.
Phase
Work Area
Start Date
End Date
Tree Removal
Michigan to Miami
September 2021
October 2021
SIdewalk and Curb Replacement
Michigan to Miami
October 2021
November 2021
Intersection Replacement
Michigan to Miami
November 2021
May 2022
Tree Planting
Michigan to Miami
May 2022
May 2022
PROPERTY ACCESS
Access to properties will be maintained throughout the project. Driveway approaches will be restricted during removal and installation. Every effort will be made to minimize interruption to property access for residents, customers, employees, and deliveries.
As part of its implementation of the Southeast Neighborhood Master Plan, the City of South Bend is making streetscape improvements along Dubail Ave between Michigan and Miami streets. Per the master plan, these improvements focus on providing a sense of place and improving walkability and bike-ability.
PROJECT AREA The project area will be made to the 10-block section of Dubail Ave between Michigan & Miami streets. Street trees will be planted within the tree lawn (area between curb and sidewalk) in May 2022.
Items to be replaced
Items to be added
Items to be removed
ADA curb ramps
Alley and driveway approaches
Curbs
Sidewalks (areas in less than good condition only)
Drainage structures at intersections
Street paving at intersections
Pedestrian bumpouts at each intersection
Street trees
Driveway approaches that are no longer needed or can be consolidated.
Street trees that are dead, dying or in poor health
PROJECT SCHEDULE
Phased construction is scheduled to begin before end of October 2021. Work on the following phase to begin once current phase is complete. All dates are subject to change.
Phase
Work Area
Start Date
End Date
Tree Removal
Michigan to Miami
September 2021
October 2021
SIdewalk and Curb Replacement
Michigan to Miami
October 2021
November 2021
Intersection Replacement
Michigan to Miami
November 2021
May 2022
Tree Planting
Michigan to Miami
May 2022
May 2022
PROPERTY ACCESS
Access to properties will be maintained throughout the project. Driveway approaches will be restricted during removal and installation. Every effort will be made to minimize interruption to property access for residents, customers, employees, and deliveries.
The Southeast Neighborhood is located just south and east of downtown South Bend. It is bounded by Sample Street to the north, Miami Street to the east, Ewing Avenue to the south and Michigan Street to the west. It is immediately adjacent to Michigan Street which is a major north/south corridor that goes through downtown South Bend and extends north into the state of Michigan and to the south towards Indianapolis.
Project Timeline
Design Plan Finalized
Dubail Avenue Streetscape Improvement Project has finished this stage
June 2021
Project Advertised to Bidders
Dubail Avenue Streetscape Improvement Project has finished this stage
July 2021
Open and Award Bid
Dubail Avenue Streetscape Improvement Project has finished this stage
August 2021
Construction Starts
Dubail Avenue Streetscape Improvement Project is currently at this stage
October 2021
Construction Completed
this is an upcoming stage for Dubail Avenue Streetscape Improvement Project
